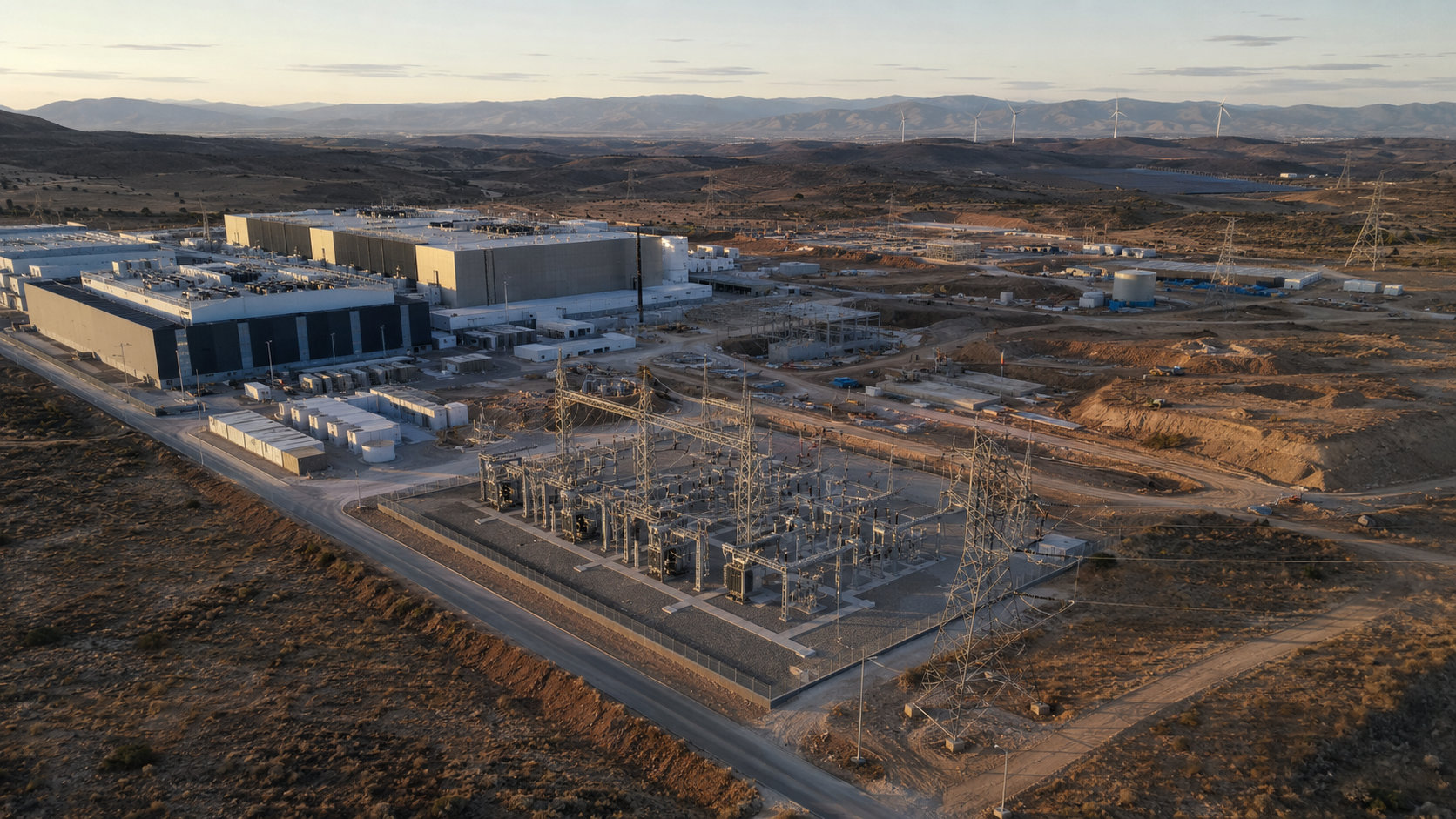

IREN’s Nostrum Deal Is Really a Bet on Power, Not 490MW of Ready-Made AI Capacity

IREN has completed its acquisition of Spanish data center developer Nostrum Group, giving the company a foothold in Europe and access to approximately 490 megawatts of secured, grid-connected power.

That headline number is likely to attract most of the attention. It also risks creating the wrong impression.

IREN has not acquired 490MW of operating AI data centers. The portfolio is not described as fully built, energized, equipped with GPUs or backed by signed customer contracts. What IREN has bought is the groundwork for future development: access to power, a pipeline of potential sites and a local team capable of moving those projects forward.

That may prove valuable. In the current AI infrastructure market, however, securing power is only the beginning.

IREN Closes the Nostrum Deal

IREN announced the completion of the acquisition on June 15, following the original agreement disclosed on May 7.

According to an earlier regulatory filing, IREN agreed to acquire 100% of Ingenostrum, S.L., which operates as Nostrum Group, for approximately €165 million. The amount remains subject to customary adjustments. The initial structure called for roughly 65% of the consideration to be paid in cash and the remaining 35% in IREN ordinary shares.

The closing announcement did not provide an updated purchase price, the final number of shares issued or details of any post-closing adjustment.

Nostrum brings IREN approximately 490MW of secured, grid-connected power in Spain, an additional development pipeline and more than 50 employees working across engineering, construction, project development and operations. The business will now operate under the IREN brand.

The acquisition gives IREN more than a collection of potential data center sites. It gives the company a local development organization in a market where permitting, grid access and regional execution can determine whether a project moves forward at all.

The 490MW Number Needs Context

Power capacity is one of the most commonly misunderstood figures in data center announcements.

A company can hold grid connection rights long before a facility is ready to operate. It may have secured access to electricity at a particular location without having completed the building, substation, cooling system, network infrastructure or computing deployment.

IREN’s own materials place Nostrum’s 490MW within its expansion plans for 2028 and beyond. That makes it a long-term development pipeline rather than near-term operating capacity.

Before the portfolio can support commercial AI workloads, IREN may still need to secure or complete land rights, local permits, financing, transmission upgrades, detailed facility design, construction, cooling infrastructure, fiber connectivity and equipment deployment.

Customer contracts are another missing piece. IREN has not disclosed a European AI tenant, colocation agreement or cloud customer tied to the acquired capacity.

The distinction is not semantic. A development right can be strategically important, especially when large electrical loads are difficult to secure. It does not generate revenue on its own.

IREN has acquired the right platform from which to build. The actual data centers still have to be financed, constructed and filled.

Power Access Is the Real Asset

The transaction reflects a broader change in how large Bitcoin mining companies are positioning themselves.

Public miners were once judged mainly by hashrate, fleet efficiency, Bitcoin production and electricity costs. The AI infrastructure boom has shifted attention toward the assets behind the mining operation: power connections, land, substations, construction experience and the ability to operate high-density computing facilities.

ASIC miners themselves offer little direct value to an AI data center. They cannot be repurposed as GPUs, and a conventional mining site is not automatically suitable for enterprise AI workloads.

The more transferable advantage lies in infrastructure.

Bitcoin miners often have experience securing large electrical loads, negotiating with utilities, developing remote sites, building substations and managing facilities that operate continuously. Those capabilities can shorten part of the development process for AI and high-performance computing.

They do not eliminate the differences between the two businesses.

AI facilities usually require more sophisticated networking, tighter reliability standards, advanced cooling systems and service-level commitments that do not exist in the same form at a Bitcoin mine. The customer relationship is also different. A mining company uses its own computing equipment to generate Bitcoin, while an AI infrastructure provider may need to support cloud users, enterprise tenants or long-term data center customers.

Nostrum appears to give IREN some of the development expertise it would otherwise need to build from scratch in Europe.

That is likely the more important part of the acquisition. IREN is not simply replacing mining machines with GPUs. It is acquiring a regional platform capable of developing large computing projects.

Spain Gives IREN a European Foothold

Spain offers an attractive electricity profile for energy-intensive infrastructure.

Red Eléctrica reported that renewable sources accounted for 55.5% of Spanish electricity generation in 2025. Including estimated self-consumption, the share reached 56.6%. The country also added nearly 10GW of wind and solar capacity during the year.

That generation mix can help support the lower-carbon infrastructure targets increasingly demanded by large technology companies and enterprise customers.

It does not guarantee that Nostrum’s individual projects will receive cheap or consistently renewable electricity.

Project economics will depend on the actual grid connection, local congestion, power purchase agreements, transmission capacity and the cost of any required upgrades. National generation figures provide useful context, but they do not reveal the electricity price or energy mix at a particular data center site.

IREN has also not disclosed the exact location, development stage or planned energization date of each project within the 490MW portfolio.

Those details will matter more than the national average once construction begins.

Bitcoin Mining Still Pays Most of the Bills

IREN increasingly presents AI Cloud Services as its main growth opportunity, but Bitcoin mining remains a substantial part of the company.

For the quarter ended March 31, 2026, IREN reported approximately $111.2 million in Bitcoin mining revenue. AI Cloud Services generated about $33.6 million over the same period.

The gap shows that IREN is still in the middle of its transition.

The company has said that mining revenue is expected to decline as infrastructure is redirected toward AI. At its Childress campus in Texas, IREN plans to phase out Bitcoin mining as facilities are converted for other computing workloads.

That does not amount to an immediate company-wide exit from mining.

IREN remains exposed to Bitcoin prices, network difficulty, global hashrate, machine efficiency and electricity costs. At the same time, it is taking on a separate set of risks tied to AI infrastructure: GPU supply, construction costs, customer demand, utilization and long-term financing.

For a period, the company will have to manage both businesses at once.

That transition may create new opportunities, but it also introduces the possibility that mining revenue declines before new AI capacity is ready to replace it.

The Hard Part Starts After the Acquisition

The purchase price is only one component of the capital IREN may need to deploy in Spain.

Building hundreds of megawatts of AI data center capacity can require substantial spending on buildings, electrical systems, cooling, fiber networks, servers and GPUs. Depending on design and equipment density, the eventual development cost could be far larger than the acquisition itself.

IREN has not yet disclosed the required capital expenditure, financing structure, construction schedule or expected return for the Nostrum portfolio.

The use of IREN shares for roughly 35% of the initial consideration also raises a dilution question. The final effect cannot be assessed until the company discloses the number of shares issued and any adjustments made at closing.

Customer commitments will be equally important.

A long-term cloud, colocation or build-to-suit agreement could materially improve the value of a power-connected site. Without a customer, the company still carries development and financing risk while waiting for capacity to be absorbed.

The next meaningful disclosures are therefore likely to come from project-level execution: final transaction figures, site locations, permits, construction starts, energization dates, GPU deployments and customer contracts.

Until then, the 490MW figure should be treated as development potential rather than operating AI capacity.

IREN now has a credible platform for expanding into Europe. It has acquired power access, a local team and a pipeline large enough to matter.

What it has not acquired is 490MW of finished data centers or guaranteed AI revenue.

The transaction reinforces a trend already visible across the mining industry. As miners move toward AI infrastructure, the most valuable asset is often no longer the machine producing hashes. It is the power connection behind it—and the ability to turn that connection into a working data center.
